Cleanup at Alameda Point continues to unfold. Every month the Restoration Advisory Board meets to stay apprised of the happenings and offer comments. The public is invited to attend on the first Thursday of the month, 6:30 p.m. at the rear of City Hall West at Alameda Point. Here are some highlights from the February meeting and a “Point Being” video update on the Seaplane Lagoon.

Site 1 – Burn Area Larger Than Expected

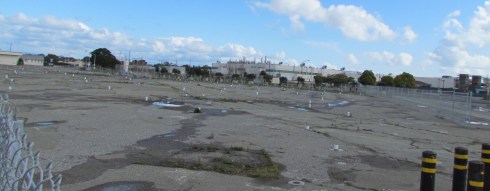

There’s a glitch in the ditch at Site 1 out at the northwestern tip, in the Northwest Territories. This is one of two of the Navy’s industrial dumps (aka disposal sites – the other one being Site 2 to the south on the Wildlife Refuge), and plans were on the calendar to begin the remediation plan on the 30-acre Site 1, which is set to become recreational open space, this year. But instead of 2013, it will now be 2015 before we are throwing Frisbees, riding the Bay Trail, or launching kayaks on the windy, incomparable western shore.
The plan was, and still is, to install a four-foot engineered soil cap on top of the site, after digging out and hauling away refuse from the burn area, where things like railroad ties were burned, which makes up a small part of the site. But as the Navy contractor was doing prep work for a detailed work plan, they discovered that the old burn area is larger than expected and that soil under the burn area “exceeded remediation goals,” which at the very least means more testing to find out what else is there.
The revelation comes as something of an embarrassment to the Navy and the regulators. After amassing over 43,000 pages of data, reports and analysis over the course of a decade for this one dump, inspection methods failed to identify all the mysteries that lie below. The inspection process is called site characterization and is at the center of almost every discussion.
Addressing the added work, however, is more complicated than a simple work order change. The Record of Decision (ROD) issued in November 2009, which lays out the cleanup work to be done, is part of the Superfund process and must contain an accurate description of contamination. It has to be amended, and this can take up to a year and a half.
Petroleum Program

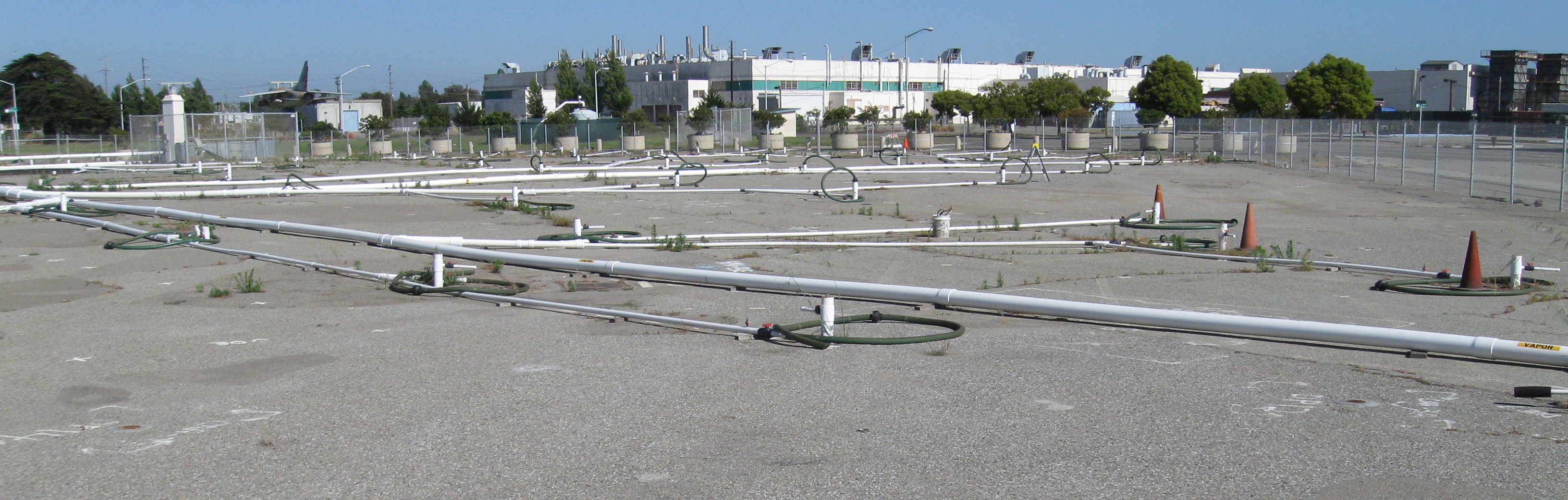

There are 251 petroleum sites above and below ground at Alameda Point. One of the most easily visible sites is just to the right of the landscape island at the East Gate. The remediation of the underground fuel contamination here was recently completed. The pipes that were snaking around the property have been removed, leaving only pipe stubs in the ground. Whether there will be a monitoring period, and how long, before construction can take place will be determined later this year.


Even though there are all of these petroleum sites, the petroleum program here and elsewhere in the country is not part of the Superfund/CERCLA process. The stated goal for this waiver of the process is that it provides a less cumbersome regulatory approval process – the chemicals are familiar, and the available cleanup options are straightforward – so the cleanup process could move faster.
The Restoration Advisory Board (RAB) gets regular updates from the San Francisco Bay Regional Water Quality Control Board (the Water Board), which is the lead agency for the petroleum program and also part of the overall cleanup regulatory team for Alameda Point. Fifty-four petroleum sites are “closed,” which sounds like “off limits,” but really means completed. One hundred thirty-three sites need additional work.
Seaplane Lagoon
Coming up
Missed radium-226-contaminated sewer pipe under the Sports Complex property? Demolition estimate on the massive million-square-foot Building 5. And more progress on cleanup. The Navy has spent $450 million on Alameda Point cleanup so far, which includes $100 million committed but not yet spent. They’ll need another $96 million before completion, and they expect to be funded at roughly $30 million a year.
Originally published on The Island.
